Construction site operations

Construction site operations

As per EN 15978 the site impacts from construction works are reported in the A5 module. To read more about life cycle stages (modules), go here.
One Click LCA enables to add construction site operation related impacts using project-specific data or use our climate zone average impacts.

Using project specific info for site impacts

For some certification schemes you need to add specifically defined site impacts, for instance, BREEAM UK NC 2014 scheme requires the inclusion of fuel used for the excavation works. In such cases include only what is necessary and leave other questions empty.
If you have project-specific data available, fill in questions 2.-4. on the 'Construction site operations' tab.
Add total consumption of location-specific electricity, and district heating in kWh. Add fuel use in a suitable unit for your fuel type.
Add total consumption of water use in m3, and waste produced in kg.

Using Construction site scenarios (climate zone averages)

Select suitable climate region and include building area in m2.
  • The averages are including average impacts per climate region for electricity and fuel consumption, and waste production.
  • Nordic countries have available average impacts for different energy impacts.

Additional trips for the transport to the construction site

This section can be used to include impacts from transportation of construction materials which require additional trips to the site or to include multiple transportation modes for single material row (from Building materials tab). Here is an example of including multiple transportation modes for construction materials:

1000 kg of steel is transported from manufacturer to the construction site
Distance between manufacturer and the site is 500 km
  • 400 km is transported with Large delivery truck 9 ton capacity (100% fill rate)
  • 100 km is transported with  Roro/Ropax ship

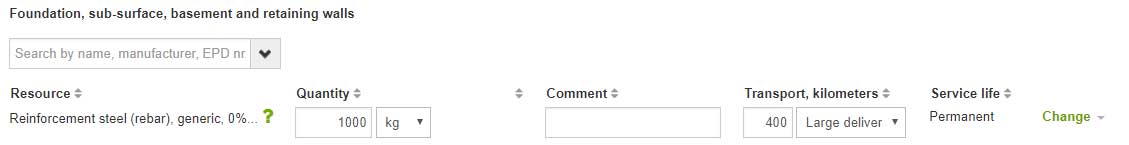

Include one transportation mode and respective distance to the 'Building materials' tab to the material resource

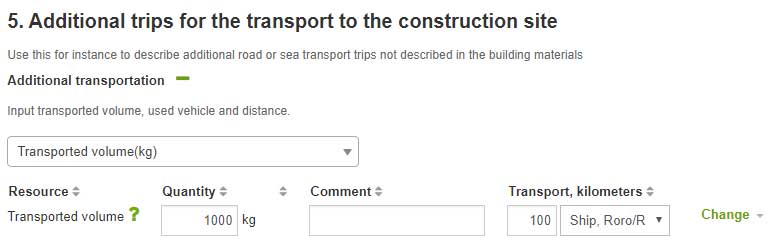

Include second transportation mode and respective distance to the 'Additional trips for the transport to the construction site' question


    • Related Articles

    • Annual carbon impacts chart

      What does this feature do? This chart shows the annual carbon impacts over the set calculation period of your project. How do you use this feature? Navigate to the results page and scroll almost all the way down, there you will find the annual ...
    • Mat 01: Life cycle impacts (UK NC 2011 and 2014)

      Life Cycle Assessment for BREEAM UK NC 2011 and 2014 This guidance supports our IMPACT-compliant and IMPACT-equivalent tools (IMPACT-equivalent has since been renamed to 'LCA for BREEAM UK'), which are designed to achieve Mat 01 exemplary credits by ...
    • Mat 01: Life Cycle Impacts (BREEAM Int & RFO)

      Mat 01 LCA for BREEAM Intl & RFO This guide is for LCA in compliance with BREEAM International 2013/2015/2016 as well as BREEAM-NOR 2016, BREEAM España and BREEAM UK RFO 2014 for Mat 01 Life cycle impacts. The LCA allows achieving full 100 % of the ...
    • Energy impacts

      In One Click LCA database, the impacts of electricity and district heat have been calculated using the energy production fuel mixes provided for each country by IEA (International Energy Agency). The impacts of the fuels (both production and exhaust) ...
    • Mat 02: Environmental impacts from construction products (UK NC 2018)

      Here's how to get your Mat02 credit for the BREEAM UK 2018 scheme The Mat02 credit can be achieved by using the 'LCA for BREEAM UK' tool Select the Mat02 EPD classification on the 'Building materials' question form:  Get your Mat02 output on the ...
